I would rather lose a job by telling you the real number than win it by telling you a small one. The small number always grows, and it grows on your side of the table.DT · Owner, BH Builders
How we price your project
Remodeling prices vary enormously because no two homes, and no two wish lists, are the same. Rather than a vague "it depends," here is exactly how we arrive at your number:
For a number specific to your rooms, run the free Quick Estimate: a one-page PDF budget built from the ranges on this page.
- Free on-site consultation. We visit your home, take measurements, and look at the real conditions behind the project, the things that actually drive cost.
- Scope & selections. We help you define what’s in and out, and the material tier you want, so the estimate reflects your project, not an average one.
- Line-item written estimate. You receive a detailed breakdown of materials and labor, you can see what each choice costs and adjust before we start.
- Fixed price you approve. You sign off on the number before any work begins. Changes only happen through written change orders you approve.
Home renovation cost in Denver, by project size
“How much does a home renovation cost in Denver?” has no single answer, because the phrase covers everything from one refreshed bathroom to a house taken back to the studs. The useful way to think about it is by the size of the project, because that is what decides which trades show up and for how long:
| Project scale | What it usually means | Typical Denver-metro range |
|---|---|---|
| One room, cosmetic | New finishes in an existing layout, a bathroom refresh, a kitchen facelift | $12k to $40k |
| One room, full remodel | Layout changes, new plumbing or electrical, new everything | $27k to $180k+ (kitchens run highest) |
| Finishing unfinished space | A basement build-out with bedroom, bath and living area | $35k to $150k+ |
| Multi-room renovation | Kitchen plus baths, or a whole floor, in one project | $60k to $250k |
| Whole-home renovation | Every room, systems and envelope, managed as one job | $60k to $700k+ |
| Adding space | A room addition, suite or full second story | $100k to $500k+ |
| New building on your lot | Detached ADU, garage or ground-up home | $100k to $450k+ for ADUs; custom homes from $200k |

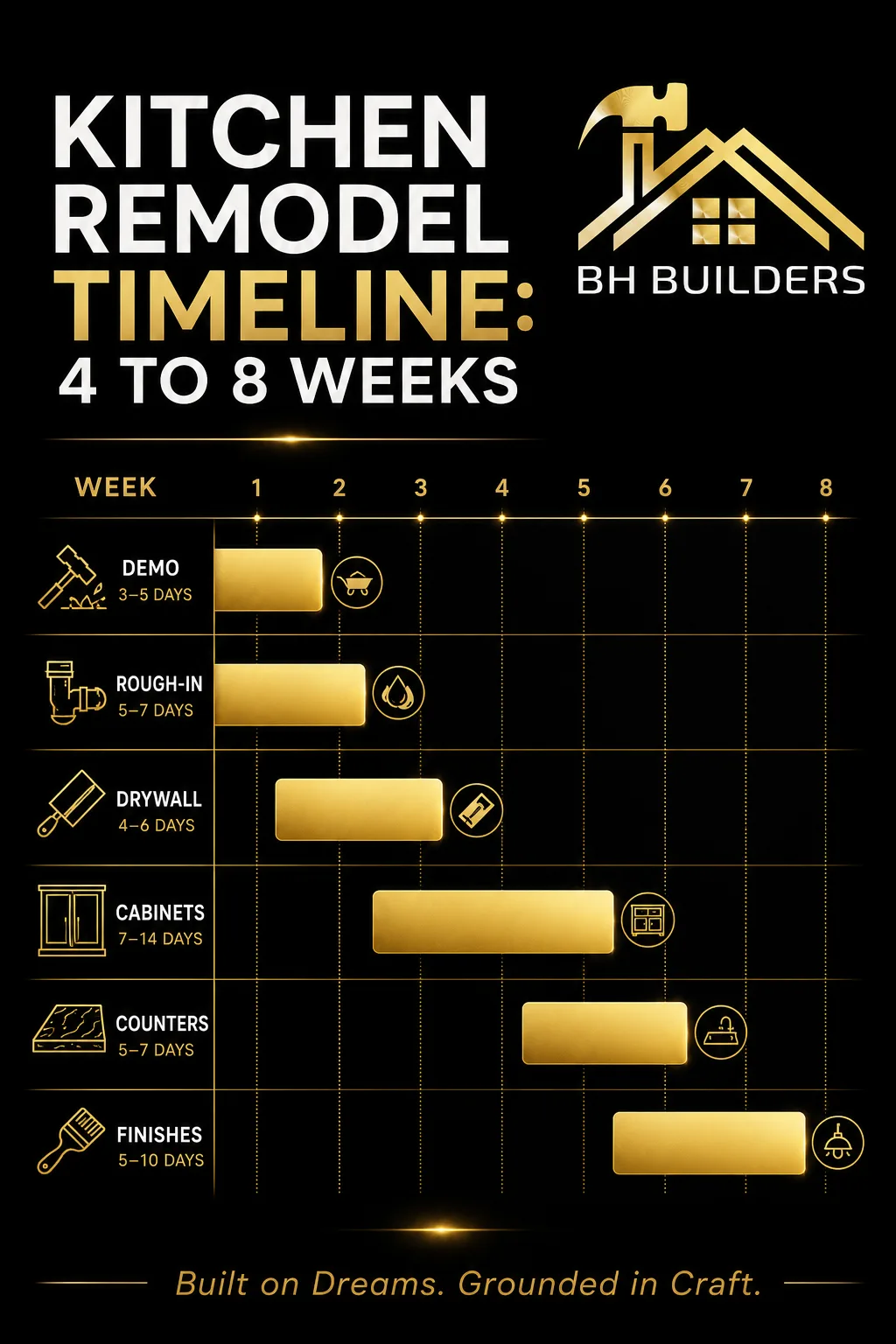

Three things move a home renovation’s cost more than anything else in the Denver metro: how much plumbing and electrical is being moved (rerouting is where mid-century homes get expensive), the age of the house (pre-1978 homes bring lead-safe practices, older wiring and out-of-square framing), and the finish tier, which is why the tier guide below names real products rather than adjectives. The service-by-service table next gives you the starting price for each project type, and every service page has a calculator that prices your version of it in about a minute.
Denver remodeling pricing at a glance
Starting prices reflect a straightforward project at a solid, mid-grade material level. Typical ranges cover most of the projects we build; large, high-end or structurally complex jobs can exceed them.
| Service | Starting at | Typical range | Details |
|---|---|---|---|
| Kitchen Remodeling | $27,000 | $27k to $180k+ | Kitchen page → |
| Bathroom Remodeling | $12,000 | $12k to $90k+ | Bathroom page → |
| Basement Finishing | $35,000 | $35k to $150k+ | Basement page → |
| Home Additions | $100,000 | $100k to $500k+ | Additions page → |
| Whole-Home Renovation | $60,000 | $60k to $700k+ | Renovation page → |
| Decks & Exterior | $25,000 | $25k to $80k+ | Decks page → |
| Roofing | $15,000 | $15k to $80k+ | Roofing page → |
| Exterior Remodeling | $10,000 | $10k to $120k+ | Exterior page → |
| New Building / ADU | $100,000 | $100k to $450k+ | ADU page → |
| Custom Home Building | $200,000 | $200k and up | Custom homes page → |
Figures reviewed October 21, 2026. What moves a project up or down the range is covered in what affects your price.
What each finish tier actually buys, named, not vague
Every estimate we produce is tagged with a finish tier, and every price in our calculators scales with it. "Budget" and "luxury" are meaningless words until someone names what's inside them, so here is what the tiers mean at BH Builders, in real products you can go look at:

| Category | Budget | Standard | Premium | Luxury |
|---|---|---|---|---|
| Cabinets | Quality stock lines (Hampton Bay, Diamond NOW) | Semi-custom (KraftMaid, Diamond, Fabuwood) | Upscale semi-custom & entry custom (Omega, Decorá) | Full custom shops, inset doors, specialty veneers |
| Countertops | Laminate / entry granite | Quartz (Silestone, Cambria entry, MSI) | Premium quartz & quartzite (Cambria, Caesarstone) | Exotic stone, marble, porcelain slab, waterfall edges |
| Faucets & fixtures | Delta, Moen core lines | Delta & Moen upgraded, Kohler | Kohler premium, Brizo, Grohe | Brizo, Waterworks, Kallista, custom finishes |
| Appliances | Frigidaire, GE, Amana | Whirlpool, LG, Samsung, KitchenAid | Bosch, Café, JennAir, Fisher & Paykel | Thermador, Wolf, Sub-Zero, Monogram |
| Tile | Ceramic field tile | Porcelain, classic subway & hex | Large-format porcelain, natural stone accents | Handmade (Zellige, Fireclay), bookmatched stone |
| Flooring | Quality LVP (Lifeproof-class) | Premium LVP (COREtec), engineered oak | Wide-plank engineered hardwood | Site-finished hardwood, specialty formats |
| Windows (additions) | Vinyl (Milgard-class) | Fibrex/composite (Andersen 100/200) | Fiberglass & clad wood (Pella, Andersen 400) | Marvin, panoramic systems (LaCantina, Western) |
| Decking | Pressure-treated pine | Cedar or entry composite (Trex Enhance) | Mid composite (Trex Select/Transcend, TimberTech) | PVC (AZEK), steel framing, glass rail |
Two things to know about how we use this table. First, tiers can be mixed, a Standard kitchen with one Premium splurge (say, the faucet you touch twenty times a day) is often the smartest money on the whole project. Second, we are brand-agnostic: nobody pays us referral fees, so the brand we spec is the one that fits your project, not a quota.
Brand price guide, what the names cost, installed
Homeowners research brands before they call a contractor, so here are honest installed planning figures for the products people ask about most. (Installed = the product plus our labor, connections and haul-away; your written estimate is exact.)
| Item | Typical brands | Installed from | Worth knowing |
|---|---|---|---|
| Appliance package (4-piece) | Frigidaire/GE → Bosch/KitchenAid → Wolf/Sub-Zero | $7,000 / $13,000 / $28,000+ | Counter-depth refrigerators transform how a kitchen looks |
| Kitchen faucet | Delta, Moen, Kohler, Brizo | $450 to $2,500 | Buy the valve quality, not just the shape |
| Quartz countertops | MSI, Silestone, Cambria, Caesarstone | ~$193/sq ft | Slab-yard visits beat samples, veining is per-slab |
| Walk-in shower system | Kohler, Delta, Schluter waterproofing | from ~$14,850 | The waterproofing brand matters more than the tile brand |
| Smart toilet / washlet | TOTO Washlet, Kohler, Bio Bidet | from ~$5,100 | Needs an outlet at the toilet, we wire it during rough-in |
| Composite deck (300 sq ft) | Trex, TimberTech, AZEK | from ~$18,000 | Hidden fasteners & picture-frame borders are the premium tells |
| Windows (per opening) | Milgard, Andersen, Pella, Marvin | $800 to $3,500+ | In Colorado, ask for low U-factor first, brand second |
| Panoramic door system | LaCantina, Western Window, NanaWall | from ~$27,000 | The single biggest wow in an addition |
| Mini-split heat pump | Mitsubishi, Daikin, Fujitsu | from ~$8,100 | Heats efficiently below 0°F, the 2026 default for additions |
| Interior door package (whole home) | TruStile, Masonite solid-core | $350 to $900/door | Solid-core doors are the cheapest "expensive house" upgrade |
Smart home, AI & new gadgets, what the tech actually costs
2026 smart-home tech has crossed the line from gadget to infrastructure, and the cheapest time to install any of it is while your walls are already open for a remodel. These are the same options our calculators price, with the brands we install:
| Upgrade | Brands we install | Installed from | Why it earns its keep |
|---|---|---|---|
| Smart lighting & scenes | Lutron Caséta / RA3, Leviton | ~$2,700 | Movie night, dinner, 2 a.m., one tap or a voice command; the highest-satisfaction tech per dollar |
| AI voice control hub | Amazon Alexa, Google Home, Apple HomeKit / Matter | ~$1,825 | Ties lighting, climate, locks and music into one assistant, we set up the routines before we leave |
| Smart appliance package | Samsung Bespoke AI, LG ThinQ, GE Profile | ~$6,075 upgrade | Ovens that watch the roast, fridges that see their shelves, 2026's AI is genuinely useful in the kitchen |
| Leak detection + auto shutoff | Moen Flo, Phyn | ~$1,350 | Kills the water main the moment a line fails, insurers increasingly discount for it |
| Touchless / smart faucet | Moen Smart Faucet, Delta VoiceIQ, Kohler | ~$1,485 | "Dispense two cups" while both hands hold the bowl |
| Heated floors | Schluter DITRA-HEAT, WarmlyYours | ~$41/sq ft | The luxury people rank first after living with it, smart-thermostat scheduled |
| Smart mirror & bath tech | LED anti-fog mirrors, Bluetooth vent fans (Broan, Homewerks) | ~$1,485 to $2,025 | The spa-bathroom layer |
| Whole-home audio | Sonos architectural, in-ceiling wired | ~$4,050 | Wired during the remodel = no speakers on shelves ever |
| Smart thermostat / zoning | Ecobee, Nest | ~$1,015 | Pays for itself; required brain for heat-pump systems |
| EV-ready circuit / charger | Emporia, ChargePoint, Tesla Universal | ~$2,000 with charger | Trenchless while walls are open; panel capacity checked first |
| Security & cameras | Ring, Nest, UniFi Protect | ~$1,500 to $4,000 | Wired PoE during construction beats battery cams forever |
| Mesh networking (wired backhaul) | eero, UniFi | ~$1,200 to $2,800 | The invisible upgrade every other smart device depends on |
2026 design trends, and what each one costs to have
Trends are just decisions with a price tag. The ones defining 2026 Denver remodels, with honest cost impact:
| Trend | What it is | Cost impact |
|---|---|---|
| Warm neutrals & wood tones | Cream/mushroom palettes, white oak everywhere | Neutral, a choice, not an upcharge |
| Two-tone kitchens | Contrast island or lower cabinets | +$0 to 1,500 (finish logistics) |
| Full-height backsplash | Counter material or slab tile to the uppers | +$1,500 to 5,000 by material |
| Fluted & reeded texture | Island backs, vanity fronts, feature walls | +$800 to 3,000 per element |
| Curbless spa shower | Zero-entry, linear drain, bench & niche | from ~$19,600 (bath calculator prices it) |
| Panoramic indoor-outdoor wall | Folding/sliding glass to a deck | from ~$27,000 + deck |
| The working pantry | Concealed back-kitchen / appliance garage | +$4,000 to 12,000 by size |
| Statement stone island | Veined quartzite/porcelain, waterfall ends | +$3,000 to 10,000 over standard quartz |
| Income suite / ADU conversion | Basement rental unit with private entry | from ~$35,100 bundle (basement calculator) |
| Hidden bookcase door | Yes, really | ~$4,725, nobody has ever regretted it |
Where the money actually goes, service by service
Every project type has its own cost anatomy, the line that quietly eats a third of the budget. Knowing yours before you start is how you steer the spend:

- Kitchens: cabinets are king, commonly 30 to 40% of the project, followed by appliances and counters. Labor concentrates in plumbing/electrical relocation and tile. That's why refacing and keeping the sink where it lives are the two biggest savers. Full breakdown: kitchens cost section.
- Bathrooms: the wet area rules. Waterproofing + tile labor make the shower the most expensive few square feet in your house, a curbless spa shower can be half the project. Fixtures are jewelry by comparison. Full breakdown: bathrooms cost section.
- Basements: it's the invisible middle, framing, insulation, drywall, electrical spread across hundreds of feet (~$85/sq ft at our standard tier). Specialty rooms (theater, cellar, gym) stack as packages on top; that's exactly how our Dream Basement Builder prices it. Full breakdown: basements cost section.
- Additions: structure and envelope, foundation, framing, roof tie-in and windows, take roughly half before a single interior finish. Soft costs (design, engineering, permits) run ~10 to 12% and are the most commonly "forgotten" line in competitor bids. Our phase-by-phase calculator shows all eight sequences. Full breakdown: additions cost section.
- Whole-home: kitchens and baths absorb half the budget between them; systems (panel, plumbing, HVAC) are the sleeper line that separates a real renovation from a cosmetic one. Full breakdown: whole-home cost section.
- Decks: material choice swings the number more than size, the framing underneath costs the same whether you deck it in pine or AZEK, which is why composite's premium looks smaller the bigger the deck gets. Full breakdown: decks cost section.
What affects your price
Two kitchens the same size can differ by tens of thousands of dollars. These are the factors that move the number most:

- Scope of change. A same-footprint refresh costs far less than moving walls, plumbing or gas.
- Material tier. Stock vs. custom cabinets, laminate vs. quartz, wood vs. composite, finishes are where budgets stretch or shrink.
- Structural work. Removing load-bearing walls, new foundations and second-story loads add engineering and labor.
- Systems. Upgrading electrical panels, plumbing, HVAC or adding a bathroom below grade adds cost.
- Site conditions. Older homes hide surprises, outdated wiring, failed waterproofing, or code items that must be brought current.
- Permits & inspections. Required for most projects; we include them so there are no surprise fees.
- Finish level & complexity. Intricate tile, custom millwork and high-end fixtures raise both material and labor cost.
How to compare contractor bids apples-to-apples
When three bids for the "same" project span $40k to $70k, the numbers usually aren't measuring the same job. Before you celebrate the low one, check what it's quietly missing:

| Check | What a complete bid shows | The low-bid trick |
|---|---|---|
| Permits | Included, filed by the contractor | "By owner" or absent, you inherit the liability |
| Allowances | Realistic named figures (tile $X/sq ft, fixtures $Y) | Lowball allowances that guarantee overages later |
| Demolition & disposal | Line-itemed with haul-away | Vague or excluded, hello, surprise dumpster bill |
| Waterproofing spec | Named system (e.g., Schluter, bonded membrane) | "Standard shower prep", the words before a 5-year failure |
| Change-order policy | Written pricing & sign-off process | Silence, the profit is planned for mid-project |
| Payment schedule | Milestone-tied, small final payment at walkthrough | Half up front, vague milestones |
| Insurance & license | Offered without being asked | "We can get you that", check DORA yourself |
Our estimates are built to survive this checklist, that's the practical meaning of "no surprises." Bring us a competing bid and we'll walk you through the differences line by line, including the places where the other bid is legitimately better. It happens; we'd rather you know.
Ten ways to trim a remodel budget, without cheapening the result
There's a right way and a wrong way to save money on a remodel. The wrong way cuts what you can't see (waterproofing, wiring, prep) and sends the bill to future-you. The right way makes smart trades on what you can see. Our ten favorites:
- Keep the layout. The moment plumbing, gas or walls move, cost jumps. A same-footprint remodel buys the most transformation per dollar.
- Reface instead of replace when cabinet boxes are sound, the look of new for roughly half the cabinet line.
- Mix your tiers. Standard everywhere, Premium on the two things you touch daily (faucet, hardware). Nobody can tell; you can.
- Choose quartz patterns over exotic slabs. Today's printed quartz mimics $200/sq ft stone convincingly at half the price.
- Big-format tile, simple layout. Labor follows tile count and pattern complexity, large tiles laid straight cost meaningfully less than mosaics and herringbone.
- Spend on lighting, save on decor. A $2,700 lighting plan upgrades every other surface in the room for free.
- Standard-size everything. Custom-size windows, doors and inserts carry 30 to 50% premiums. Design to stock dimensions where it doesn't hurt.
- Phase the wants, build the needs. Rough-in the future bath now ($3,375) and finish it in two years, infrastructure while walls are open, finishes when budget returns.
- One mobilization. Bundling the hall bath into the kitchen project shares demo, dumpsters, permits and our setup, two projects for less than two prices.
- Decide early, change never. Mid-project changes carry change-order pricing and schedule cost. The cheapest decision is the one made before demolition.
What’s included in our pricing
Our estimates are meant to be the number you actually pay. A BH Builders estimate includes:
- Design and planning support, and a fixed written scope.
- All labor across the trades we self-manage and coordinate.
- Materials at the tier you select, itemized so you can adjust.
- Permits and inspection coordination with your local jurisdiction.
- Site protection, dust containment and daily cleanup.
- Our workmanship guarantee on the finished work.
Payments & financing
We keep payments simple and tied to progress, so you are never paying far ahead of the work:
- Deposit to reserve your spot on the schedule and order materials.
- Progress payments at agreed milestones as the project moves through its phases.
- Final payment only after the final walkthrough, when every punch-list item is closed.
Many homeowners finance larger remodels through a home-equity line of credit (HELOC), a renovation loan, or a contractor-financing partner, we’re happy to point you toward reputable options during your estimate. Certain efficiency upgrades may also qualify for rebates or the federal energy-efficient home improvement credit.
| Milestone | Typical share | What's been delivered by then |
|---|---|---|
| Signing / scheduling deposit | 10 to 20% | Your slot reserved, materials ordered, permits filed |
| Demolition & rough-in complete | 25 to 30% | Old space out, new plumbing/electrical in & inspected |
| Cabinets / tile / major installs set | 25 to 30% | The space visibly transformed |
| Finishes complete | 20 to 25% | Flooring, paint, fixtures & hardware done |
| Final walkthrough | 5 to 10% | Every punch-list item closed, you approve before paying |
Exact milestones and shares are written into your agreement per project, the principle never changes: payments follow delivered work.
Rebates & tax credits worth checking before you remodel
A surprising amount of remodel tech qualifies for money back, especially the efficiency layer. We flag these during your estimate, but the short list:
- Federal Energy Efficient Home Improvement Credit (25C): a tax credit for qualifying heat pumps, insulation & air sealing, and efficient windows/doors, heat-pump systems (like the mini-splits we install in additions) are the headline item. Confirm current-year limits with your tax professional.
- ENERGY STAR rebates: the Rebate Finder lists live offers by ZIP for appliances, water heaters and smart thermostats.
- Xcel Energy rebates: Colorado's utility runs rebates on heat pumps, smart thermostats and insulation that stack with federal credits.
- Insurance discounts: leak-detection systems with auto-shutoff (Moen Flo, Phyn) earn premium discounts from several insurers, ask yours.
We don't inflate estimates around incentives, the price is the price, but we'll make sure the paperwork trail (model numbers, invoices) is clean so you can claim what you're owed.
When to remodel, timing, seasons & lead times
Timing doesn't change our rates, but it changes your experience and your calendar. For the full start-to-finish ranges, design, selections, permit review and construction, see how long a Denver remodel really takes. What actually matters:
- Interior projects are season-proof. Kitchens, baths and basements build beautifully in a Colorado winter, and winter/early-spring calendars book easier than the post-tax-refund spring rush.
- Additions & decks want the ground. Foundations and footings prefer thawed soil, so exterior projects designed in winter break ground first in spring, the design-and-permit phase (3 to 6 weeks) is the perfect cold-month work.
- Lead times are the real schedule. Semi-custom cabinets run 4 to 8 weeks, custom 8 to 14; specialty windows and panoramic doors 6 to 12. We order at contract signing so the clock runs during permits, not after demo.
- The best time is before the failure. Remodeling a failing shower on your schedule costs a fraction of remediating the rotted subfloor on its schedule. If you've seen the warning signs, the cheap month is this one.
Why we quote ranges, not one-size prices
Some companies advertise a single low "kitchen remodel" price to get the phone to ring, then the number climbs once the real scope is known. We would rather be honest up front: a range tells you where most projects land, and the free on-site estimate turns that range into an exact, fixed price for your home. No bait, no moving target, the price you approve is the price you pay, changed only by work you request in writing.
The bottom line on pricing at BH Builders: we publish our starting points, we name the brands behind our tiers, our calculators show the math line by line, and the estimate you sign is the number you pay. Premium craft has a real cost, laser-leveled cabinets, Schluter-grade waterproofing, permits on every job, and one accountable person answering your calls aren't free, but it should never have a mysterious cost. If any number on this page raises a question, call (720) 980-3913 and ask; straight answers are the cheapest thing we sell.
Cost guides at a glance
Real BH Builders work across the Denver metro, no stock photos. Tap any photo to zoom. See the full project gallery →



Serving remodeling and construction services across the Denver metro
BH Builders is based in Greenwood Village and provides remodeling and construction services to homeowners throughout the Denver metro and the surrounding Front Range. Wherever you are, you get the same licensed, insured crew, the same fixed written pricing, and the same standard on every job. We regularly work in these communities and the neighborhoods around them:
- Denver
- Greenwood Village
- Centennial
- Littleton
- Highlands Ranch
- Aurora
- Englewood
- Lakewood
- Parker
- Castle Rock
- Lone Tree
- Cherry Hills Village
- Arvada
- Berkley
- Brighton
- Broomfield
- Castle Pines
- Commerce City
- Federal Heights
- Foxfield
- Golden
- Ken Caryl
- Lafayette
- Louisville
- North Washington
- Northglenn
- Sherrelwood
- Thornton
- Todd Creek
- Welby
- Westminster
- Wheat Ridge
Don’t see your town on the list? If you’re anywhere in the greater Denver metro, call (720) 980-3913: there’s a good chance we serve your area, and the estimate is always free.
I won’t give a homeowner a number over the phone, because a number without seeing the work is a guess, and guesses turn into arguments later. What I will give you is an honest range up front and an exact, written price after I’ve stood in your home. That’s how you keep trust.DT · Owner, BH Builders
Frequently asked questions
Are your estimates really free?
Why can’t you give me a price over the phone?
How much deposit do you require?
Do you offer financing?
Will the final price match the estimate?
Do your prices include permits?
Do brand names really change the price that much?
What does remodeling cost per square foot in Denver?
How much should I set aside for smart home tech?
Is there a cheapest season to remodel in Denver?
Want an exact price for your project?
Every estimate is free, on-site and line-itemed, no obligation.
📞 Call (720) 980-3913 Schedule a Free Meeting
